For this past week’s municipal complex activity, we continue to wait for Schindler, the elevator company, to finish their week and call for inspections from the state inspector. Meanwhile, crews worked on exterior stairs and railing, exterior trim work, landscaping, creation of the rear emergency access road, as well as installation of benches and trash cans. Inside, work was finishing up on mechanical, electrical and plumbing finishes, millwork in the Council chambers, carpet was installed in the Council chambers, and sinks are being installed soon in the various staff break rooms.

For the week ending November 6, 2020 at the Berkeley Heights Municipal Complex project site, the following took place:

  • EPIC and their subcontractors had an average daily manpower count of 33 workers.
  • EUC graded on the north side, placed topsoil, prepped for the access road and north side sidewalks, and swept the parking lots to being preparing for top coat asphalt.
  • Industrial Cooling Corporation installed HVAC finishes and began demobilization.
  • Epic Interiors taped, placed ceiling tile, worked on doors and hardware, installed toilet accessories, and began demobilization.
  • Mehl Electric installed electrical finishes, wired door security, worked on the IT and security racks, programmed the lighting, installed the elevator shunt trip, and wired for motorized shades.
  • Artisans Showcase of Tile tiled the elevator cab floor.
  • Fine Painting painted the Police Department entrance lobby, various rooms in the basement, and the exterior stair railings on the north and west sides.
  • Epic Millwork installed crown molding in the Council Room.
  • All American Surfaces installed flooring in the janitor closets, the Community Meeting Room, and the Council Room, and continued installation of vinyl base throughout.
  • 18 Glass substantially completed exterior door glass.
  • Central Jersey Landscaping placed mulch, grass seed, and hay.

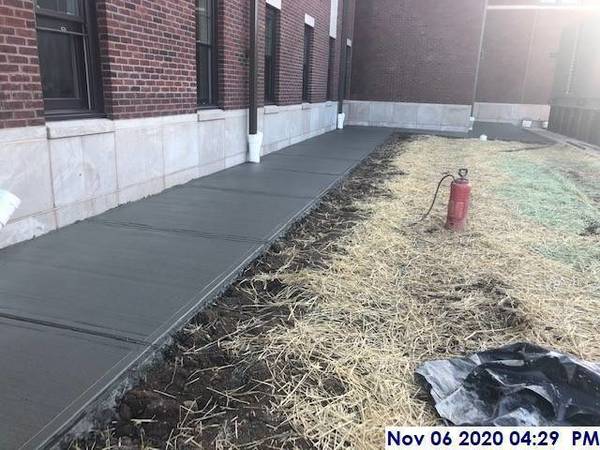

  • Top Line poured the north side sidewalks.
  • Hi Tech Steel installed the railing at the Stair #1 exterior landing.
  • Net Q continued server room work.


2020-11-08 21:37:00Z
https://www.tapinto.net/towns/berkeley-heights/articles/berkeley-heights-municipal-complex-update-for-week-ending-nov-6

CBMid2h0dHBzOi8vd3d3LnRhcGludG8ubmV0L3Rvd25zL2JlcmtlbGV5LWhlaWdodHMvYXJ0aWNsZXMvYmVya2VsZXktaGVpZ2h0cy1tdW5pY2lwYWwtY29tcGxleC11cGRhdGUtZm9yLXdlZWstZW5kaW5nLW5vdi020gEAMehl

No comments:

Post a Comment
